When people search “how to install solar street light”, most aren’t installing a small garden lamp—they’re building road, highway, industrial park, campus, or village lighting where failure becomes a safety issue and a maintenance burden.
At BOSUN, we treat installation as part of system engineering: correct location, correct foundation, correct pole geometry, correct commissioning. That’s also why we provide free DIALux lighting design for project layouts—so the pole spacing, road width, and lighting distribution are validated before any concrete is poured.
Below is a contractor-ready installation process you can follow on-site.
Before You Install: Choose the Right System Type
All-in-One Solar Street Light (fastest installation)

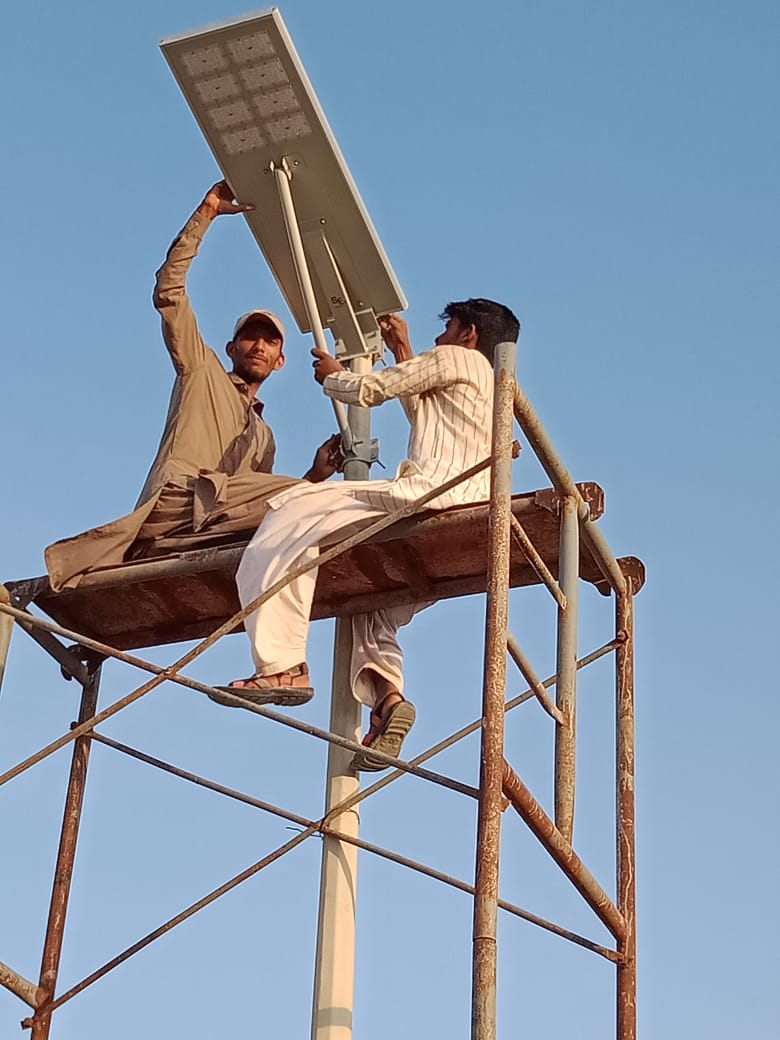

All-in-one models integrate solar panel + battery + controller + LED into one unit—so the on-site work is mainly pole + bracket + fixture mounting + aiming + commissioning. BOSUN notes that all-in-one installation can be very fast (two workers, no heavy equipment, minutes-level mounting in simple conditions).
Best for: municipal roads, rural roads, industrial parks, resorts (when you want fast deployment).
Split Solar Street Light (more flexible in tough sites)
Split systems separate the panel and battery/lighting head, so you can:
-
optimize panel angle (useful if shading is a risk)
-
place components for easier service or better thermal control
-
use longer poles / higher power configurations more flexibly
Best for: higher-power roads, complex sites, projects needing flexible panel placement.

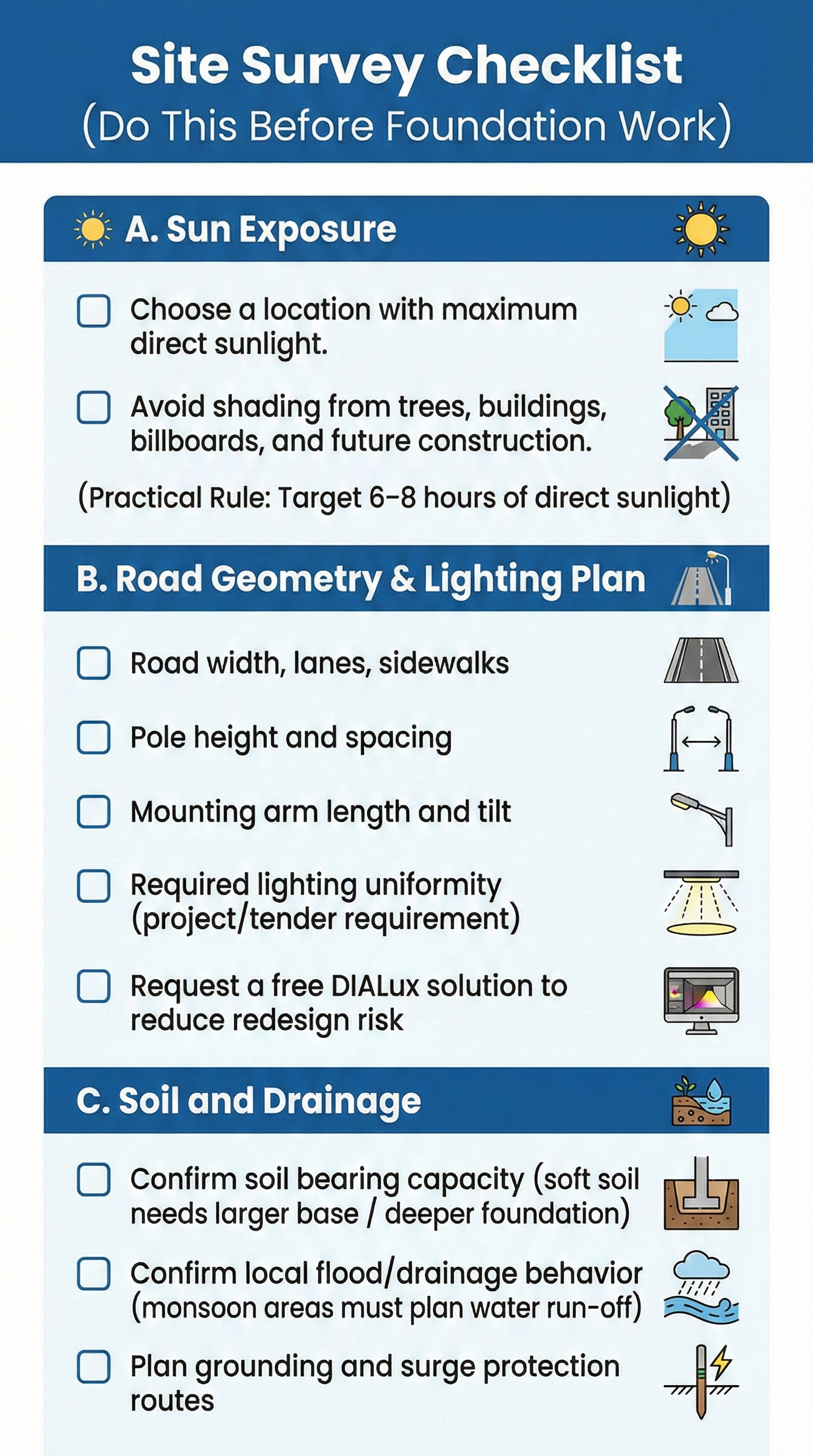

Site Survey Checklist (Do This Before Foundation Work)
A. Sun exposure
-
Choose a location with maximum direct sunlight.
-
Avoid shading from trees, buildings, billboards, and future construction.
(Some BOSUN guidance references a 6–8 hour direct-sunlight target as a practical rule of thumb during site selection.)
B. Road geometry & lighting plan
-
Road width, lanes, sidewalks
-
Pole height and spacing
-
Mounting arm length and tilt
-
Required lighting uniformity (project/tender requirement)
If you don’t have a layout yet, request a free DIALux solution to reduce redesign risk and avoid over/under-lighting.
C. Soil and drainage
-
Confirm soil bearing capacity (soft soil needs larger base / deeper foundation)
-
Confirm local flood/drainage behavior (monsoon areas must plan water run-off)
-
Plan grounding and surge protection routes
How to Install Solar Street Light With Pole (Step-by-Step)
Step 1 — Mark positions & set spacing
Use your lighting design plan (or DIALux layout) to mark:
-
pole centers
-
setback from curb/road edge
-
spacing intervals (one-side or two-side installation)
Step 2 — Build the foundation correctly
Foundation errors are the #1 reason for leaning poles and premature structural failure.
Typical workflow:
-
Excavate according to pole height and local wind load assumptions
-
Install anchor bolts and rebar cage
-
Pour concrete and cure to design strength
-
Re-check bolt alignment and top level before erecting pole
(Depth and cage design vary by pole height, soil type, and wind zone—follow your civil drawings.)

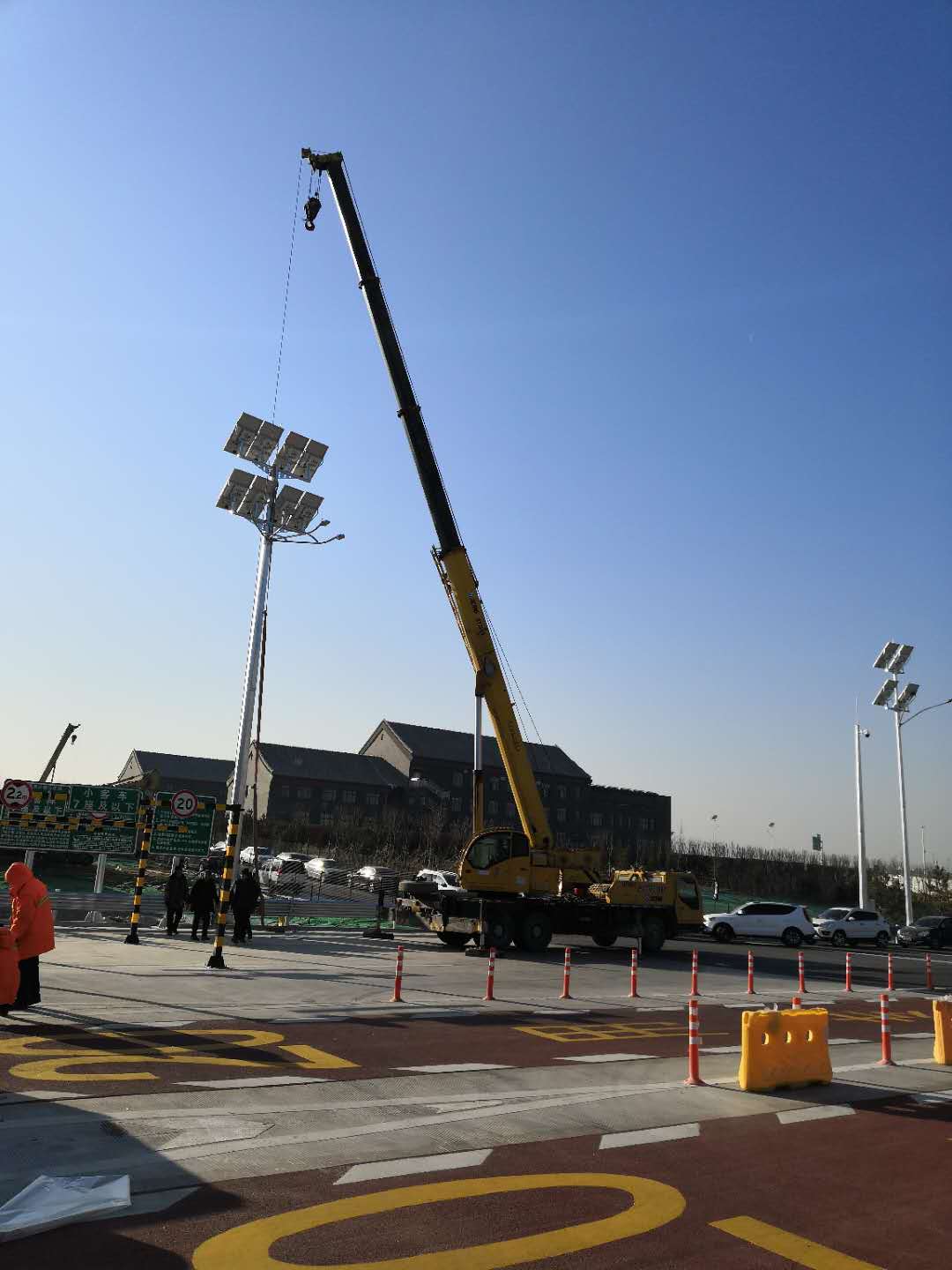

Step 3 — Erect the pole and torque bolts
-
Use the correct lifting method (crane or manual method depending on pole)
-
Torque anchor bolts to spec
-
Confirm verticality with level tools (two directions)
Step 4 — Mount bracket / arm and install the fixture

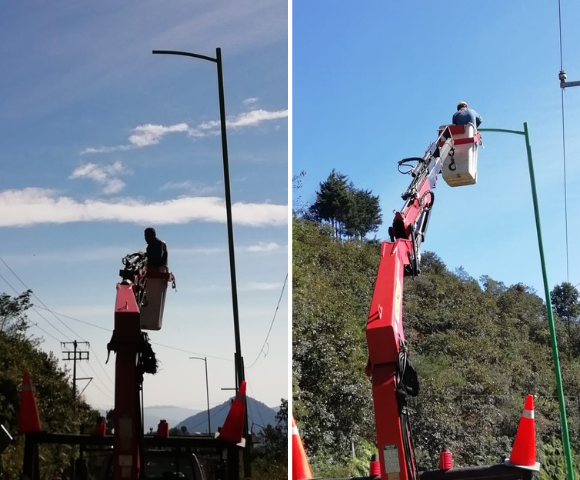

For All-in-One models
-
Mount bracket
-
Lift and bolt the integrated light onto the bracket
-
Adjust angle (panel/fixture angle if adjustable)
BOSUN highlights that all-in-one installation is designed to be simple and fast in the field.
For Split models
-
Mount lamp head on pole/arm
-
Mount solar panel (separate) on top or side bracket
-
Route and secure cables using protective conduits (avoid sharp bends)
-
Confirm waterproof connectors are properly seated
Some BOSUN split-series pages emphasize “plug & play” concepts to reduce switching points and improve durability.
Step 5 — Wiring & connector safety checks (critical)
-
Verify polarity before connecting battery/controller harnesses
-
Confirm all waterproof connectors are fully locked
-
Tie and protect cables from rubbing, vibration, and UV exposure
Step 6 — Commissioning (turn-on logic, profile, and aiming)
-
Ensure panels are unshaded
-
Confirm dusk-to-dawn behavior and sensor response (if included)
-
Set dimming profile / operating mode (if remote or programmable)
-
Aim the fixture to the designed road distribution
Remote Control / Smart Control Setup (What Buyers Search Next)
Many project users also search “solar street light remote control manual” because commissioning often includes mode selection.
General commissioning best practice:
-
Match operating mode to energy model: full brightness all night is not always optimal; dimming profiles can extend autonomy.
-
Test response and stability: verify switching and dimming over at least 1–2 full nights during handover.
-
Document settings: record mode, dimming schedule, and any sensor thresholds in the handover sheet.
If your project requires remote monitoring, BOSUN also offers smart/IoT configurations on some split-system solutions.

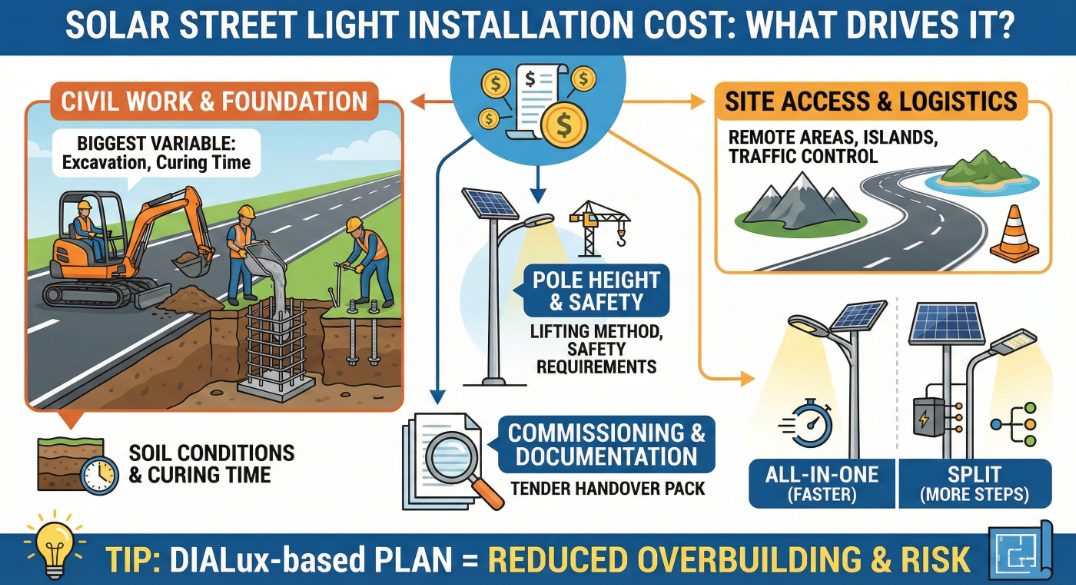

Solar Street Light Installation Cost: What Actually Drives It
If you’re estimating solar street light installation cost, don’t only count labor hours. In real projects, installation cost is mostly driven by:
-
Pole + foundation scope (civil work is the biggest variable)
-
Soil conditions and curing time
-
Site access (remote areas, islands, traffic control)
-
Pole height, lifting method, and safety requirements
-
Whether it’s all-in-one (faster) vs split (more steps)
-
Commissioning and documentation requirements (tender handover pack)
Tip: If your project has road drawings, a DIALux-based plan can reduce overbuilding (too many poles) and reduce rework risk.
Maintenance Checklist (Keep It Running for Years)
A simple solar street light maintenance checklist prevents most “not working” complaints.
Monthly / Quarterly (environment-dependent)
-
Clean panel surface (dust, salt, bird droppings)
-
Inspect fixture lens and heat dissipation surfaces
-
Check pole bolts and bracket integrity
-
Confirm no new shading (tree growth, new signage)
Semi-Annual / Annual
-
Inspect waterproof connectors and cable routing
-
Check for corrosion at fasteners and mounts
-
Confirm controller operation and lighting profile still matches project need
If a unit fails, common field troubleshooting includes checking connector corrosion/oxidation and restoring clean contact surfaces (BOSUN’s troubleshooting guidance references connector cleaning and anti-corrosion practices).
Common Installation Mistakes (And How to Avoid Them)
-
Installing in shade → causes chronic under-charging and dimming
-
Skipping foundation engineering → pole tilt, bolt fatigue, structural risk
-
Loose waterproof connectors → water ingress and intermittent faults
-
Wrong aiming → bright near pole but dark where it matters (roadway)
-
No commissioning record → settings get changed later, performance degrades, blame shifts to hardware
Quick FAQ
Q1: Do you provide a solar street light installation PDF?
We provide project installation instructions and on-site guidance per model and project type. (For large projects, request the full handover pack: drawings, wiring diagram, commissioning sheet, and maintenance checklist.)
Q2: How long does installation take?
All-in-one installations are typically faster because there’s less wiring and fewer components on-site; BOSUN describes minutes-level mounting in simple conditions (excluding civil foundation curing).
Q3: Can you help with pole spacing and road layout?
Yes—BOSUN offers free DIALux lighting design for project layouts and optimization.
Conclusion & CTA: Want a “No-Rework” Installation Plan?
If you want an installation that passes acceptance smoothly, start with the inputs that determine everything:
-
road width and class
-
pole height preference
-
spacing constraints
-
operating hours and dimming requirement
-
site coordinates (solar resource + shading risks)
Send BOSUN your drawings (or even a simple sketch), and we’ll return a contact BOSUN plus a system configuration recommendation—so your team installs once, hands over cleanly, and avoids costly rework.
